Costs rise steeply for new school builds
The price of delivering new school buildings in Wrexham has climbed markedly, with the benchmark cost of a primary school now around 48% higher than three years ago, according to a capital investment report before the council’s Lifelong Learning Scrutiny Committee this week. Welsh Government rates cited in the paper put a typical primary at £6,433 per sq m for projects due in 2027, up from £4,340 per sq m on the 2023 benchmark.
Officers attribute the increased outlay to industry-wide construction inflation and the requirement to meet Welsh Government decarbonisation and Net Zero Carbon standards for all new school schemes. These obligations, now embedded in programme requirements, are adding to design complexity and costs but are expected to reduce operational carbon and energy usage over the life of buildings.
| Benchmark year | Primary build cost (£/sq m) |
|---|---|
| 2023 | £4,340 |
| 2027 (projected) | £6,433 |
| Change | +48% |

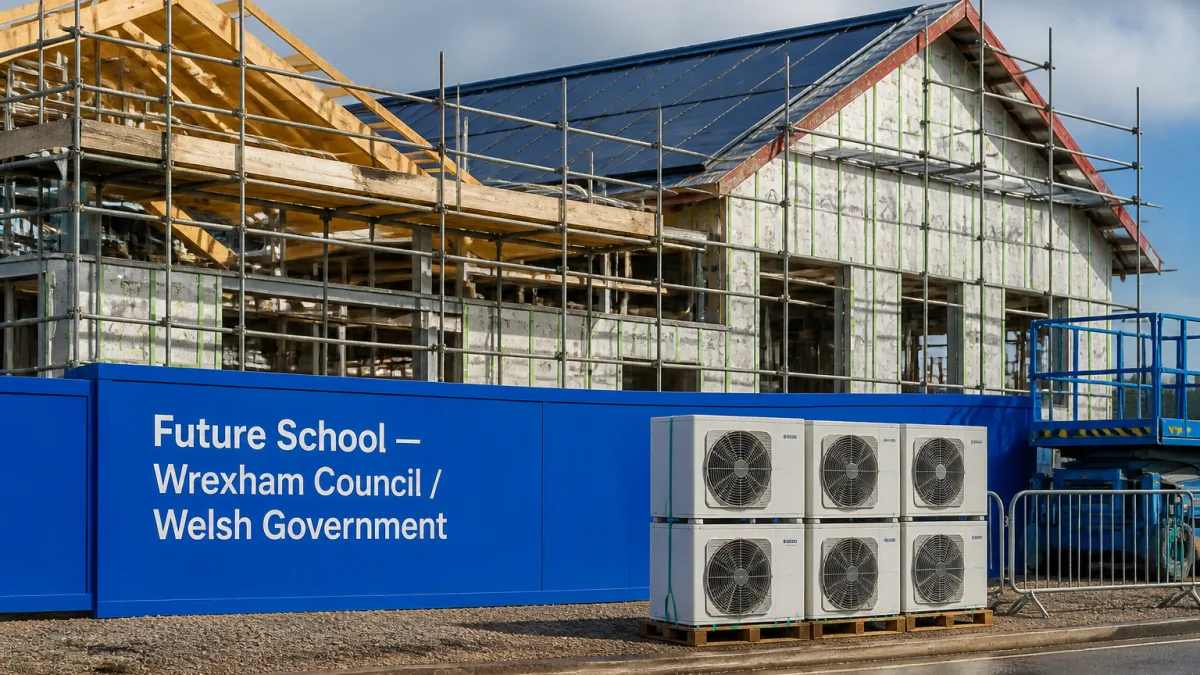

One scheme completes; three more move forward
The report confirms one project has reached completion. The Haulfan Pupil Referral Unit has transferred to the remodelled former Ysgol Yr Hafod infant site in Johnstown, providing places for up to 48 secondary-age pupils. The move from the previous Rhosddu Road base took effect from 24 June.
Three further schemes in the first phase are in train, each responding to capacity pressures or specialist needs:
- St Mary’s Church in Wales (Brymbo): A new school is planned close to Stori Brymbo and within a mile of the current building. The land is already in council ownership and a contractor is appointed. The Executive Board has signed off an increase in capacity from 154 to 210 pupils, with the design allowing potential expansion to 315. Delivery is targeted within two years.
- St Mary’s Catholic Primary (Croesnewydd Road): The school would relocate from Lea Road to a new 315-place primary with 45 part-time nursery places. The report reiterates pressures at the current city-centre site, which is landlocked and has a listed capacity of 287 but more than 320 pupils on roll, including teaching in mobile classrooms. The Outline Business Case has been approved by Welsh Government, with delivery planned within three years.
- St Christopher’s Special School: A full replacement building is proposed to serve up to 330 pupils with additional learning needs. A combined business case went to Welsh Government in October 2025, and approval to progress to a full business case followed in January 2026.
Funding profile and grant support
The paper outlines the grant intervention rates that apply to school projects, which vary by type of provision. Indicative Welsh Government support currently stands at:
| Project type | Grant rate |
|---|---|
| Local authority mainstream | 65% |
| Faith schools | 85% |
| Special education | 75% |
Higher intervention rates for faith and special education projects are designed to recognise the particular capital requirements of those settings. The balance of funding is to be met locally, with final allocations dependent on business case approvals at each stage. The report links the elevated cost environment to market conditions and the additional specification demanded by net-zero standards, underscoring the importance of firm cost control as schemes move through procurement.
Pressures, standards and the local picture
While the completion of the Haulfan PRU relieves pressure on specialist secondary provision, the pipeline schemes speak to wider demographic and estate issues. In Brymbo, the planned uplift in capacity for St Mary’s Church in Wales aims to future-proof the setting by enabling expansion if required. In the city, the proposed relocation of St Mary’s Catholic Primary responds to long-standing constraints at Lea Road, where pupil numbers exceed the stated capacity and temporary accommodation has been used to cope with demand.
Compliance with Net Zero Carbon standards brings operational benefits over time but has front-loaded some capital costs. The council’s programme team highlights that all new-builds must now meet these standards, affecting design, materials and building systems from the outset. Against this backdrop, the funding mix—particularly the higher grant rate available for faith and special provision—will be pivotal to keeping delivery on schedule.
What families and residents need to know
For parents and carers, the key points are timelines and capacity. The Brymbo scheme is programmed within two years, the Croesnewydd Road move within three, and the special school replacement continues through the business case process following gateway approval earlier this year. Each project still faces detailed design, planning and procurement steps, during which costs will be tested against the benchmarks set out to councillors.
As councillors scrutinise the capital programme, the combination of rising build prices and higher environmental standards presents a tighter financial landscape for education infrastructure. The latest benchmarks indicate that any like-for-like primary school project coming forward for 2027 delivery would need to budget around £6,433 per sq m, compared with £4,340 per sq m on the 2023 baseline. Whether these pressures will require scope adjustments or phasing will be a matter for future committee discussions as individual business cases progress.
